Creative operations 201: How to build a creative ops function from scratch

How to build creative operations
TL;DR

Scaling creative output without scaling chaos requires infrastructure, not just more people. Below are the six core components of a creative operations framework, each with specific tool recommendations, downloadable templates and an honest look at where teams get stuck. Plus a phased buildout from minimum viable creative ops to full maturity, so you can start small and grow into the system instead of trying to build everything at once.

If your creative team is producing more work than ever but missing more deadlines than ever, the issue isn't talent; it's infrastructure. You're running a growing creative operation on ad hoc processes, scattered briefs and tribal knowledge.

At some point, that breaks.

For most enterprise marketing teams, that breaking point has already happened.

Creative operations is the strategic infrastructure that governs how creative work gets requested, produced, approved and delivered at scale.

Creative operations goes beyond project management. It's the system design layer that sits underneath your creative output, which is the reason one organization can deliver 200 assets a month without breaking a sweat while another struggles with 30.

This blog is a practical framework for building creative operations from scratch, with specific tool recommendations, templates you can use immediately and an honest assessment of where most teams get stuck.

The most effective creative operations framework

Most creative operations problems trace back to the same root causes: unclear ownership, inconsistent processes,and no shared standard for what good looks like. A creative operations framework addresses all of these.

It's the system that defines how creative work moves through your organization, who owns each stage and what "done well" means.

Who does the work?Team structure, role definition and the talent model that determines whether you hire, contract, or partner for different creative capabilities.
How does work get requested and prioritized?The intake system, briefing standards and governance that determine which work gets done, in what order and with what level of information.
What process does work follow? Workflow stages, approval chains, handoff criteria and the quality gates that prevent work from reaching stakeholders before it's ready.
How do we maintain brand consistency? The asset management, brand governance and review infrastructure that keeps output on-brand as volume scales.
How do we measure success? The metrics, benchmarks and feedback loops that prove the function's value and identify where to invest in improvement.

Traditional creative ops frameworks stopped at project management, which included tracking timelines, managing workloads, moving deliverables through a pipeline.

That's table stakes now. Modern creative operations integrate brand intelligence, AI-augmented production workflows and data-driven performance optimization into the core infrastructure.

If your creative ops framework doesn't account for how AI and human creative work intersect, you're building for 2020, not for today and neither for the future.

Do you actually need creative operations?

Not every team does, at least not formally. If you're a team of five producing 10 assets a month for a single brand, you can probably coordinate informally. But if you're nodding along to any of the scenarios below, you've already outgrown informal coordination.

Score yourself honestly. If you answer "yes" to three or more of these, you need creative operations infrastructure, not more people working harder.

Requests arrive through Slack, email and hallway conversations. There's no single intake point. Work gets lost. Nobody has a complete picture of what's in the pipeline.
Your team is constantly firefighting. Designers and copywriters spend more time triaging urgent requests and chasing stakeholders for information than they spend creating. Your best creative talent is doing project management.
You can't answer "how many projects can we deliver this quarter?" with data. Capacity planning is guesswork. Hiring decisions are reactive. You don't know if you're over or underutilized until something breaks.
Brand consistency degrades as volume increases. Different designers interpret guidelines differently. Assets look disjointed across channels. Every new team member or agency partner means another round of "that's not how we use our logo."
Approval cycles are unpredictable. Feedback arrives late, in different formats, from multiple stakeholders who haven't seen each other's comments. Projects stall in revision loops. Nobody owns moving work forward.
Teams recreate assets that already exist. There's no searchable creative library. Brand assets live on individual hard drives and scattered cloud folders. Nobody knows if the banner from Q3 was ever finalized.
You're supporting multiple brands, products, or regions. Complexity compounds fast when you're managing consistency across entities, each with their own guidelines and stakeholders.
Stakeholders across departments all request creative work. Sales, product, customer success and marketing all need assets. Without intake governance, everything is urgent and nothing is prioritized.
Leadership asks for creative performance data you don't have. How long does a typical project take? What's the average number of revision rounds? What's the cost per asset? If you're shrugging, creative ops will give you the answers.
Your team has grown but your processes haven't. What worked at 3 people doesn't work at 15. The informal systems that got you here are now the bottleneck.

If you scored 3+: You need creative operations infrastructure. Keep reading, because the framework below gives you a practical build plan.

If you scored 1-2: You're approaching the tipping point. Start with the "minimum viable creative ops" section below to build lightweight foundations before things break.

If you scored 0: You're either at a very early stage or already running solid creative ops. Either way, the framework below is useful as a maturity benchmark.

The 6 core components of a creative operations framework

Each of those 5 questions maps to a core component of the framework. The sections below break down how to build each one, with specific tools, practical steps and an honest look at where most teams get stuck.

1. Creative intake and request management

Every creative operations problem starts with a bad brief. If your team consistently produces work that misses the mark, the issue is almost never creative talent; it's the quality of information they received at the start.

What enterprise-grade intake looks like in practice

Centralized request submission. One entry point for all creative requests, no exceptions. Most enterprise teams use Asana, Monday.com, or Workfront for this, with a structured intake form that routes requests automatically based on project type, urgency and requesting department. Jira works for teams that are already engineering-heavy, though it lacks native creative review features. Airtable and Notion are viable for smaller teams that want flexibility over structure.

Standardized brief templates. Every request should capture:

  • Business objective: not "make a banner" but "drive demo signups for Q3 launch"
  • Target audience: specific enough to inform creative decisions
  • Key messages: the one thing the audience should take away
  • Deliverables with specifications: dimensions, format, platform
  • Deadline with reasoning: Is this tied to a launch date or flexible?
  • Brand/product specifics: Which guidelines apply
  • Approval chain: who signs off, in what order

The brief template should make the lazy path the thorough path, with required fields, dropdown selections and reference links that make it faster to fill out correctly than to skip.

The most common briefing failures that cause rework

The fields stakeholders most often skip or fill poorly are business objective ("make a banner" instead of "drive demo signups for the Q3 product launch"), target audience (left vague or omitted entirely) and mandatory elements (legal disclaimers, required logos, character limits discovered after design is complete). If your team consistently produces work that "isn't quite right," audit your last 10 briefs; the gap is almost always in one of these three fields.

Automated routing and SLA tracking: Requests automatically route to the correct queue. The operations manager sees incoming volume, current capacity and projected delivery dates before accepting work into the pipeline. Most enterprise PM platforms support automated routing and configure rules based on project type, urgency, or requesting department.

Requestor visibility: Stakeholders can check the status without interrupting the creative team. This sounds basic, but it eliminates an enormous volume of "just checking in" messages that fragment creative focus time.

2. Workflow design and process architecture

Ad hoc workflows are the silent killers of creative operations. When every project follows a slightly different path and nobody knows when to provide input, work stalls because nobody owns moving it to the next stage.

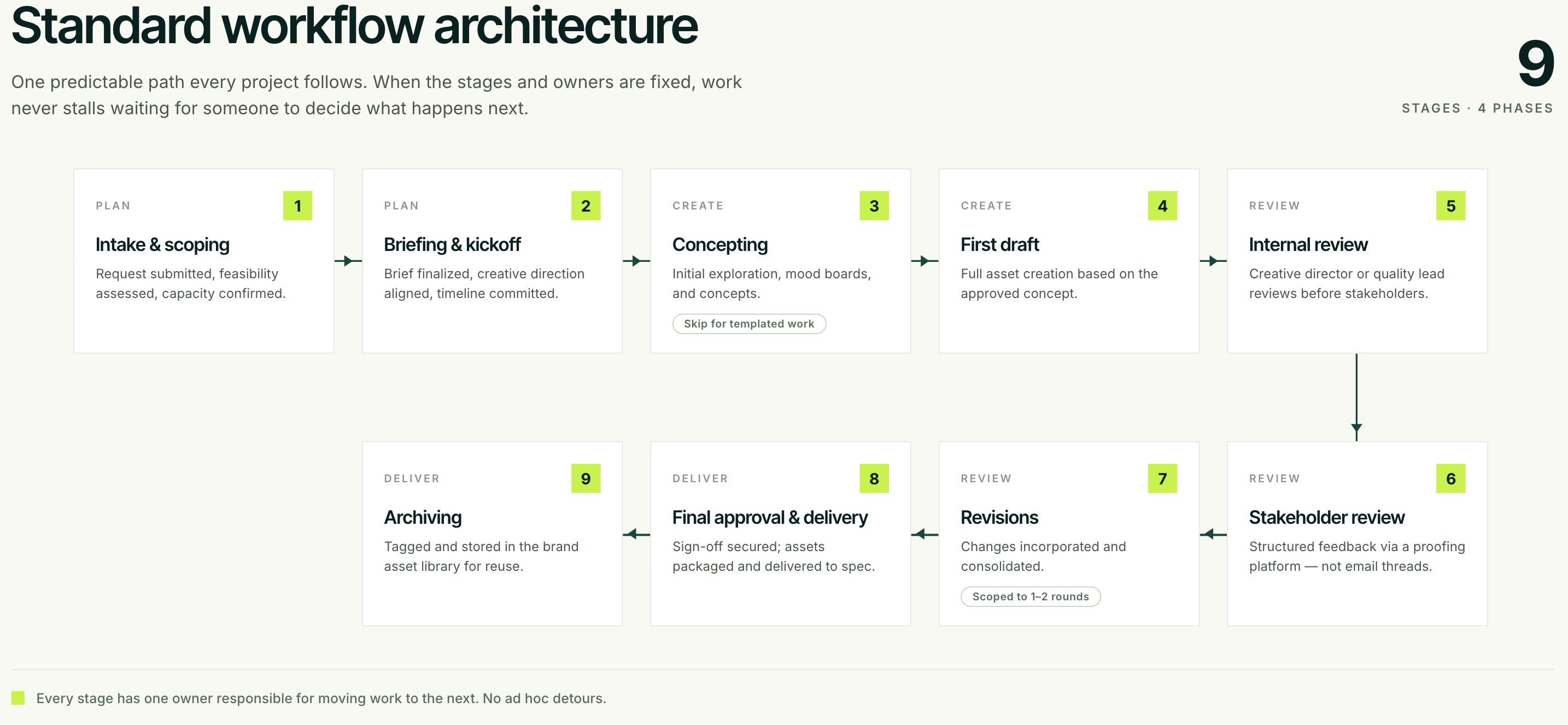

Creative team requests workflow

Different formats flex this process. A social media ad might skip concepting and go straight to the first draft. A rebrand project adds multiple concept rounds with executive review gates. Your workflow system needs to support both without workarounds. Platforms like Asana and Monday.com offer configurable project templates, while Workfront and Wrike support more complex workflow automation with conditional logic.

The non-negotiable workflow infrastructure
  • Clear ownership at every stage: Projects never sit in limbo. Every stage has a designated owner responsible for pushing work forward. If you can't point to a specific person who owns every project at every moment, that's your bottleneck.
  • Defined handoff criteria: What must be true before work moves to the next stage? What deliverables, approvals, or information must be present? Write this down. Make it a checklist. Don't assume people know.
  • Built-in quality gates: Creative director or brand review happens before stakeholders see work. This catches brand inconsistencies and quality issues early, when they're cheap to fix. AI-assisted QA layers can automate the technical checks (spec compliance, brand color accuracy, asset dimensions), freeing human reviewers to focus on strategic and aesthetic judgment.
  • Automated status updates: When work moves between stages, stakeholders get notified automatically through your PM platform. Nobody should need to manually chase updates in 2026.

3. Brand consistency and asset management

As creative volume scales, maintaining brand consistency becomes exponentially harder. This is the section where most creative ops frameworks fail, they describe what brand management is without explaining how to actually build it.

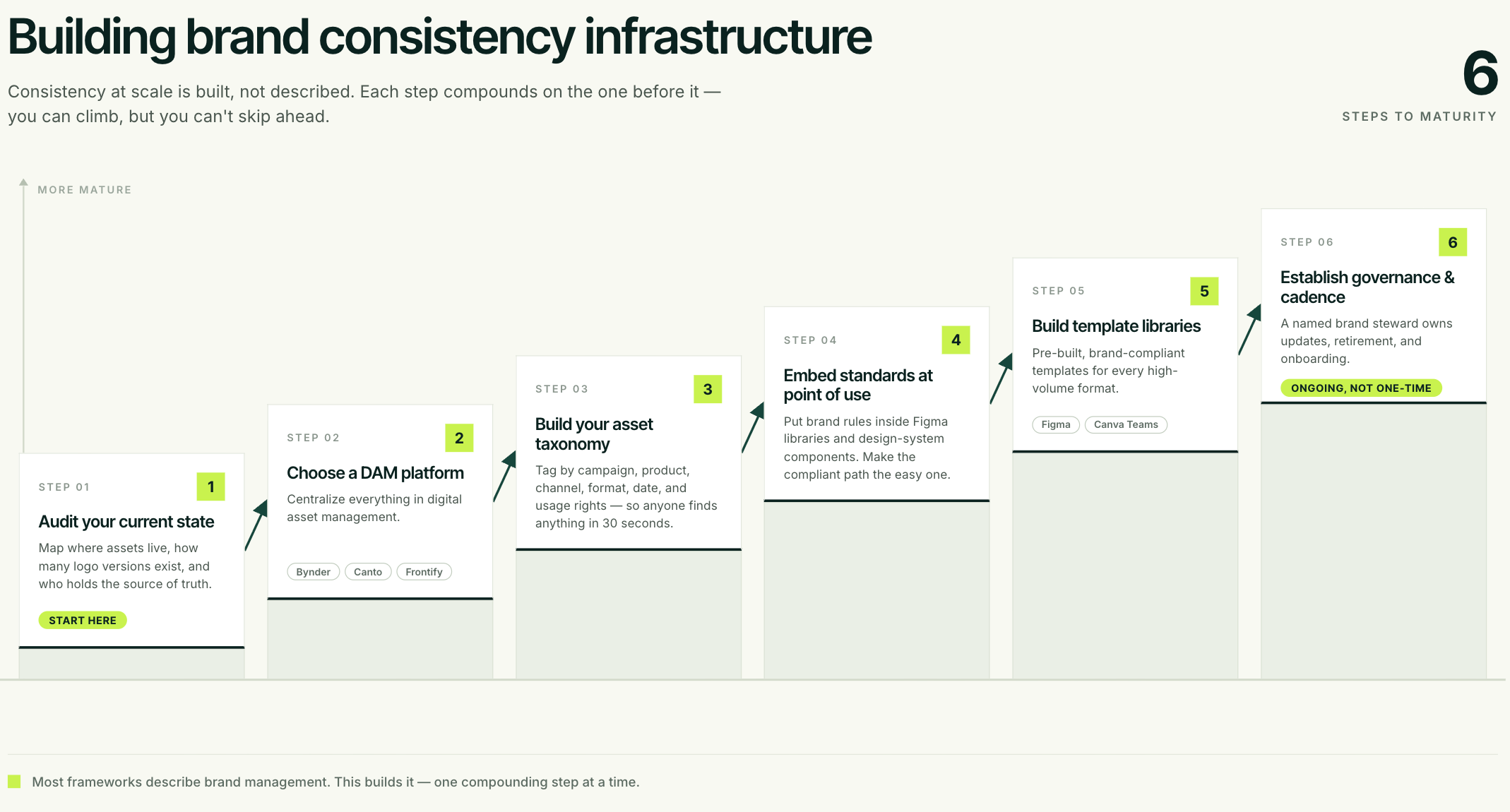

How to build a brand consistency infrastructure


Where brand consistency typically breaks down first: Logo misuse (wrong version, wrong clearspace, stretched proportions) is the most visible symptom, but the deeper problem is usually voice and messaging inconsistency, different teams describing the product differently, using outdated taglines, or inventing their own messaging hierarchy.

The second most common failure is visual system drift, where designers create "on-brand-ish" work that slowly diverges from the system because they're working from memory rather than from living design tokens and components.

4. Team structure and talent models

There's no universal "right" creative ops team structure, because it depends on your volume, complexity and whether you build, partner, or blend both. But there are roles that every functioning creative operation needs covered, whether by a dedicated hire or someone wearing multiple hats.

The roles every creative ops function needs
  • Creative Operations Manager / Director. The system designer. Owns workflows, intake, capacity planning, performance metrics and continuous improvement. This is a process and systems role, not a creative execution role. The best ops managers come from operations or program management backgrounds, not necessarily creative ones.
  • Creative Project Managers. The execution coordinators. Manage individual projects from intake to delivery. Own timelines, stakeholder communication and revision tracking. Research shows most PMs handle 2 to 5 active projects simultaneously, so plan your headcount accordingly.
  • Creative Director / Design Lead. Sets quality standards and creative strategy. Reviews work before stakeholders see it. Maintains brand integrity across all output. This role is the last quality gate before work leaves the building.
  • Production talent. Designers, copywriters, video editors, motion designers. In a well-structured creative ops function, these roles should spend the majority of their time on creative work, not managing projects or chasing approvals. Research suggests most teams currently spend less than 40% of their time on actual creative work, which is a gap that a strong creative operations infrastructure directly addresses.
  • Brand steward. Maintains guidelines, curates asset libraries and onboards new team members on brand standards. In smaller teams, this is part of the Creative Director's role. At enterprise scale, it's a dedicated function.
Enterprise talent models in practice

You don't need to hire every role full-time. Building a creative operations team is about blending models, not filling every seat.

Most enterprise creative operations blend multiple talent models:

  • Core full-time team for strategic work, brand stewardship and operations management
  • Specialized freelancers via platforms like Toptal, Behance, or industry-specific creative talent platforms for variable-demand skillsets like 3D, illustration, or specialized video production
  • Creative partners for scaled production capacity, complex campaign work, or capabilities you don't want to build in-house
  • AI-augmented production for high-volume templated work like ad variants, social assets, or email graphics, using tools like Figma's auto-layout with design tokens, or purpose-built creative automation platforms

5. Project management and delivery infrastructure

Strong creative talent still misses deadlines and loses deliverables without the right systems. Here's what the tech stack actually needs to include and why.

Platform recommendations by use case

Creative project management

  • Asana: best for teams that want flexibility and strong integrations
  • Monday.com: best for visual workflow builders
  • Workfront: most enterprise-grade, advanced resource management and proofing. Significant setup investment.
  • Wrike: solid middle ground with real-time collaboration

Proofing and feedback

  • Frame.io: video review with timestamped comments and version comparison
  • Figma: design review with inline comments and component-level feedback
  • Workfront / Monday.com: built-in proofing features work for static assets

File management

  • Google Drive, Dropbox Business, or Box with strict naming conventions and version control
  • If your team uses "final_v3_FINAL_actualfinal.pdf" file names, this is the first thing to fix

Communication

  • Slack: async coordination, one channel per project or project type
  • Loom: async video walkthroughs for creative direction that's too nuanced for text

Capacity and resource planning

  • Workfront and Monday.com have this built in at the enterprise level
  • Asana's Portfolio and Workload views cover the basics
  • Harvest Forecast is a standalone option for teams that need resource planning separate from their PM tool
Project management practices that actually stick

Kickoff meetings for complex projects

  • Align on objectives, deliverables, timeline and creative direction before production starts
  • Keep it to 30 minutes. Use a standard agenda. Document decisions, not discussion

Structured feedback rounds

  • Define how many rounds are included in scope upfront
  • Consolidate all stakeholder feedback into a single round per stage
  • Use proofing tools, not email
  • Push back on scope-expanding "small tweaks." They're the #1 source of timeline slippage

Creative briefs as contracts

  • Once a brief is approved, scope changes require formal approval and timeline adjustment
  • Without this boundary, mission creep is guaranteed

Weekly capacity reviews

  • 15-minute standing meeting where the ops manager reviews the incoming pipeline against team capacity
  • Flag resourcing issues before they become missed deadlines

6. Performance measurement

Without metrics, you can't prove creative operations’ value to leadership, identify bottlenecks, or make data-driven investment decisions.

The metrics that matter, with benchmarks

Throughput and capacity:

  • Projects completed per month/quarter
  • Average project duration by type
  • Team utilization rate (percentage of available hours on creative work vs. admin/meetings)

Benchmarks: Industry data from Asana and SPI Research shows creative and marketing teams should target 75-85% utilization. Below 70% indicates excess capacity or under-demand. Consistently above 85% signals burnout risk, you're running hot with no buffer for unexpected work.

The SPI Research 2025 Professional Services Maturity Benchmark found the industry average at 66.4%, well below the 75% optimal threshold, meaning most teams have room to improve through better operations infrastructure.

Quality and consistency

  • Average revision rounds per project (track this religiously, becase it's the single best indicator of brief quality and creative-stakeholder alignment)
  • Percentage of projects requiring more than two revision rounds (a rising trend here means briefs are getting worse or stakeholder alignment is breaking down)
  • Stakeholder satisfaction (quarterly survey, keep it simple, NPS-style)

Benchmarks: Industry standard for well-run creative teams is 2-3 revision rounds per project. If your average sits above 3, you have a briefing quality problem, a stakeholder alignment problem, or both and not a creative execution problem.

Three rounds are a reasonable maximum to scope into project agreements; anything beyond should require a formal scope extension and timeline adjustment.

Efficiency

  • Time from request to kickoff (your intake SLA, how fast does work enter the pipeline?)
  • Time from approval to delivery (your delivery SLA)
  • Cost per asset or cost per project by type
  • On-time delivery rate

Business impact:

  • Creative work's contribution to marketing KPIs (campaign performance, conversion rates)
  • Time savings from templates and reusable assets
  • Reduction in external spend (if building in-house capacity)

Start simple. Most teams can't instrument everything on day one. Begin by tracking project count, average duration and revision rounds in a spreadsheet. As the function matures, use your PM platform's built-in reporting. Asana, Monday.com and Workfront all have dashboards that automate throughput and cycle time tracking.

Creative brief template

A bad brief is the single most common cause of rework. This template gives your team a starting structure that captures every field that matters and includes a weak vs strong brief example so stakeholders understand what good looks like before they submit.

Duplicate the template → HERE

Creative intake form

This is the form your stakeholders fill out to submit a creative request. It covers deliverable specs, audience targeting, messaging and approval chains, so your team stops chasing missing information after work has already started.

Duplicate the template → HERE

Revision governance checklist

Revision loops are almost always a scoping problem, not a creative problem. This checklist gives you the boundaries to set before a project starts, the process to follow during each round and copy-paste language for the three most common scope creep scenarios.

Duplicate the template → HERE

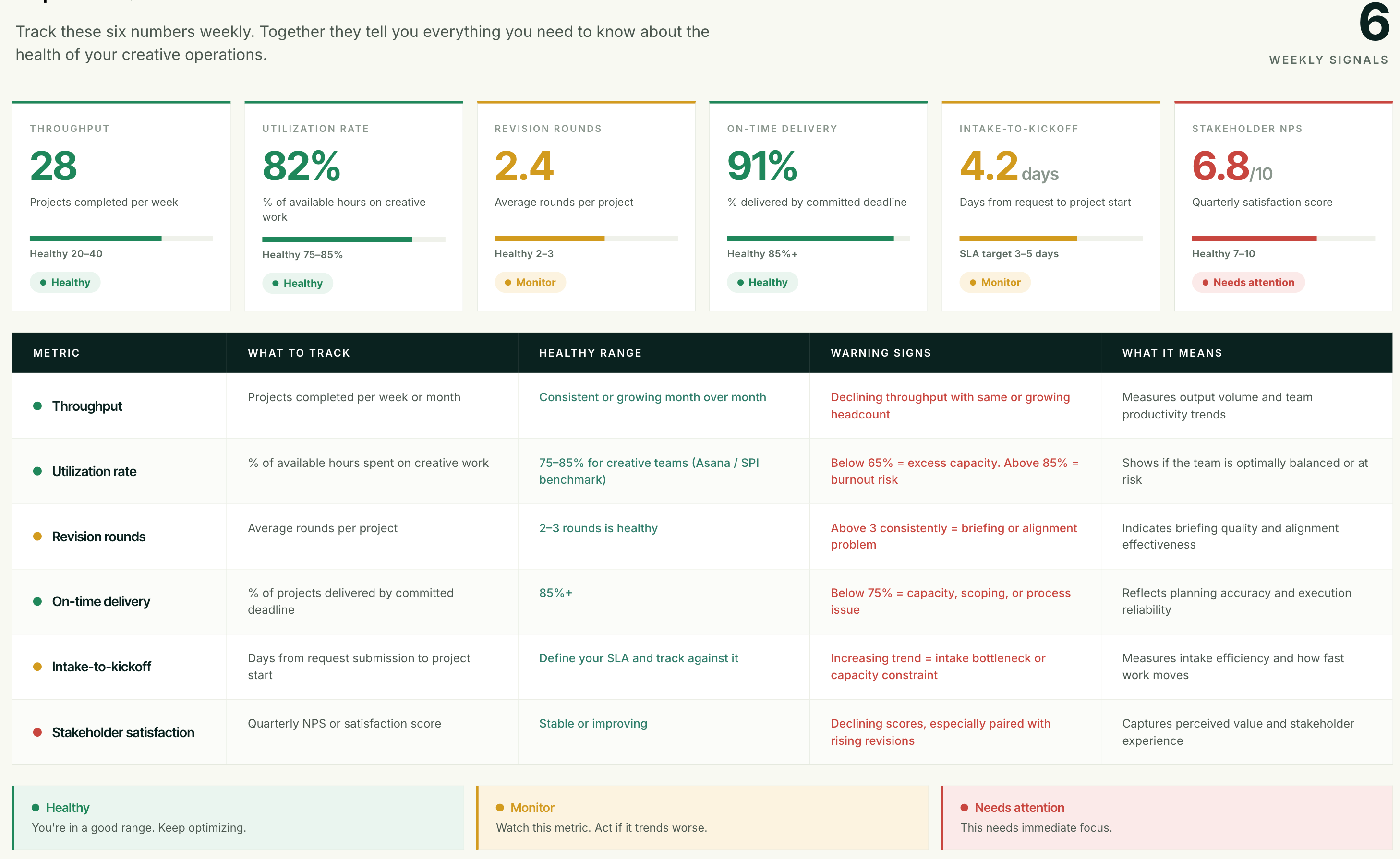

Creative ops metrics dashboard

Most creative ops teams track too much or nothing at all. These six metrics tell you everything you need to know about your operation's health and what to do when any of them move in the wrong direction.

Creative operations metrics dashboard

Duplicate the dashboard template → HERE

How to calculate utilization rate: (Total hours spent on creative project work / Total available working hours) x 100

Example: A designer works 40 hours per week. They spend 30 hours on project work and 10 hours in meetings, on Slack and doing admin. Their utilization rate is 75%.

How to use this dashboard: Review weekly with your ops team. Look for patterns, not individual data points. A single bad week is noise. Three bad weeks in a row is a signal.

When a metric trends in the wrong direction, diagnose the root cause before adding process, because sometimes the fix is removing a bottleneck, not adding a step.

Minimum viable creative ops: 5 things you can do this week

Not everyone can hire a Creative Operations Manager tomorrow. If you need to bring order to chaos with existing resources and no new software, start here.

  1. Create one intake form and enforce it. Build a Google Form with the essential brief fields listed above, or duplicate the one we've made for you. Share it with every stakeholder. Refuse to accept requests through any other channel. This single change eliminates the most common creative ops failure: incomplete information at the start of a project.
  2. Define your workflow stages and write them down. Even if it's a whiteboard or a Notion page: Request → Brief → Draft → Review → Revise → Deliver. Make it visible. Make every project follow it. The stages can be simple - the discipline of following them is what matters.
  3. Consolidate feedback into one round per stage. Tell stakeholders: all feedback goes into one document or one proofing comment thread, collected within 48 hours. Late feedback goes into the next round. Enforce this ruthlessly. Scattered feedback is the single largest source of wasted creative time.
  4. Create a shared asset folder with naming conventions. Pick a cloud storage platform. Create a folder structure by year, campaign and asset type. Establish a naming convention and enforce it. Something like: [Brand][Campaign][AssetType][Size][Version]_[Date]. This alone saves hours per week that your team currently spends hunting for files.
  5. Start tracking three numbers. Projects completed per week. Average revision rounds per project. On-time delivery rate. Put these in a spreadsheet and update weekly. Within a month, you'll have enough data to identify your biggest bottleneck and make a case for investment.

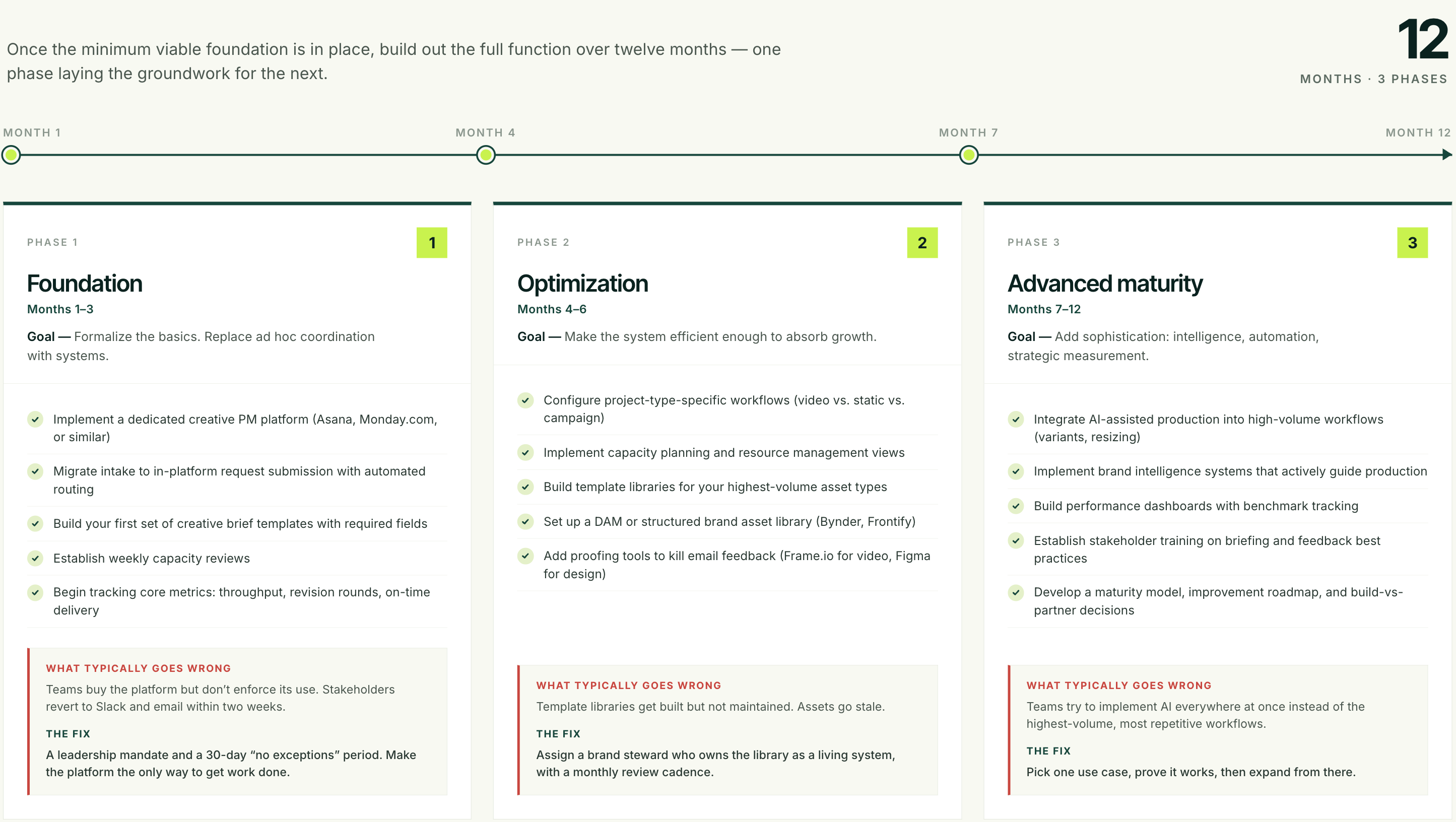

Building creative ops: A phased approach

Creative operations grows in stages. Most teams try to implement everything at once and abandon it within a month because the system feels too heavy for where they are. The phased approach below gives you a realistic sequence: what to build first, what to layer in once the foundation holds and what only makes sense at maturity.

Building creative operations

Creative operations best practices

Getting the infrastructure right is the foundation. But the teams that actually get leverage from creative operations share a set of habits that go beyond having the right tools and processes in place. These are the things that separate a function that runs well from one that compounds its value over time.

  1. Treat creative ops as strategy, not overhead. The best ops leaders sit at the table with marketing leadership, contribute to campaign planning and forecast creative capacity as a business planning input. If your creative ops function is treated as a service desk that takes tickets, it will never reach its potential.

    The failure mode: ops becomes reactive rather than predictive and the team is perpetually behind instead of ahead.

  2. Design for humans, not perfection. Complex workflows with 15 approval stages look rigorous on paper but collapse under real-world pressure. People will route around systems they perceive as bureaucratic. Build the simplest workflow that maintains quality, then add complexity only where data shows it's needed.

    The failure mode: teams abandon the system entirely because it's too cumbersome and you're back to ad hoc processes.

  3. Embed brand consistency into tools, not documents. If following brand guidelines requires opening a separate PDF and manually cross-referencing, your designers will improvise. Put guidelines inside Figma as components and styles. Use your DAM to surface approved assets contextually. Make the compliant path the easiest path.

    The failure mode: beautiful brand guidelines that nobody uses because they're not accessible at the moment of creation.

  4. Invest in feedback literacy. "I don't like it" is not feedback. "The headline doesn't emphasize the product benefit we agreed on in the brief" is feedback. Train stakeholders on how to give actionable input, it pays dividends in reduced revision rounds for years.

    The failure mode: revision loops where the creative team is trying to guess what the stakeholder actually wants because the feedback doesn't contain enough information.

  5. Protect creative time like it’s revenue. If designers spend 60% of their day in meetings, on Slack and managing requests, your operations infrastructure is failing its primary purpose. Structure workflows so creative talent creates, everything else should be handled by operations infrastructure, PM support, or automation.

    The failure mode: your best creative talent burns out or leaves because they were hired to design and they spend most of their time doing project management.

  6. Use data to defend the function's existence. Marketing leadership may view creative ops as cost-center overhead. Report regularly on throughput improvements, time-to-market reductions, revision round decreases and cost-per-asset trends. If you can show that creative ops reduced average project duration by 30% and revision rounds by 40%, nobody questions the investment.

    The failure mode: the ops function gets cut in a downturn because nobody documented its business impact.

  7. Plan for AI integration from day one. Even if you're not implementing AI systems immediately, design workflows that can accommodate AI-augmented production. Don't build processes that assume every asset is hand-crafted from scratch. That model doesn't scale and it doesn't reflect how creative production is evolving.

    The failure mode: rebuilding your entire workflow two years from now because it was designed around a purely manual production model.

FAQs

related articles
You may also like these

Top 11 AI Design Agencies & Studios for Creative Innovation in 2026

Gone are the days when AI was pure sci-fi. The mind-blowing technology is becoming part of everyday life, weaving its magic across industries. In our hyper-connected world, AI’s power is undeniable, and it’s slowly being adopted—also in the design industry. A recent report shows that 93% of web designers already use AI in design-related tasks, and 57% believe AI and machine learning (ML) will soon become essential design tools.
6 min to read

From pixels to possibilities: Superside’s CEO on the AI-creative future

If you're wondering what the future of creative work looks like, Fredrik Thomassen, CEO and founder of Superside, has a pretty clear answer: it's fast, borderless and powered by AI. In a recent episode of Lead The Team podcast, Thomassen dropped his insights on the transformation happening at the intersection of creativity, automation and global talent—and how Superside is riding that wave with confidence.
best AI ad copy generators
10 min to read

10 best AI ad copy generators in 2026 for optimized ROI

Dishing up fresh content daily has become a constant scurry. Consequently, an increasing percentage of digital marketers are using artificial intelligence (AI) to stay ahead. A recent study by Statista shows that 73% of U.S. marketers already use AI for content creation. This trend is set to continue, with digital ad spend expected to hit $870 billion by 2027—a dramatic increase from $550 billion in 2022. Another Statista report predicts the AI marketing industry will hit a staggering $107.5 billion by 2028, a huge jump from $15.8 billion in 2021.
ai design examples

10 AI Design Examples That Saved Our Clients Over $300,000

As we've been beta-testing our AI-enhanced creative services, we've become even more convinced of its power to help us work more efficiently and enable greater creativity. In fact, the data from our first 200 AI projects showed that, on average, these projects took 30% to 60% fewer hours—translating into $300,000 in savings for Superside customers. We're also incredibly proud of our nearly 100% satisfaction rating. So, we've checked the boxes for speed and cost-effectiveness. But, what about the levels of quality, creativity and impact? These 10 AI design examples more than prove that you can leverage the force-multiplying effect of AI and creative that performs.
